REPORT

AI and the Power Grid: Where the Rubber Meets the Road

Electric pylons

A new wave of early-stage data center projects is reshaping US electricity demand – and it’s doing it quickly.

Data-center power demand hits 106 gigawatts (GW) by 2035 in BloombergNEF’s newest forecast – a 36% jump from the previous outlook, published just seven months ago.

The massive growth rate in data center power demand reflects more than a surge in the number of data centers in the pipeline; it also highlights the new centers’ size. Of the nearly 150 new data center projects BNEF added to its tracker in the last year, nearly a quarter exceed 500 megawatts. That’s more than double last year’s share.

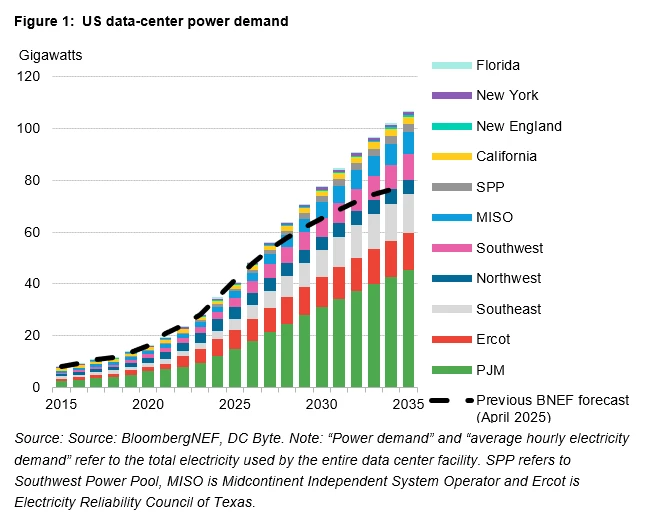

US data-center power demand

This boom in data center demand is colliding with grid realities. In PJM, BNEF forecasts data center capacity could 31GW by 2030, nearly matching the 28.7GW of new generation the Energy Information Administration expects over the same period. In the Electric Reliability Council of Texas, reserve margins could fall into risky territory after 2028, a sign that short-term growth can be absorbed, but longer-term supply will lag.

These pressures point to an inflection moment for US grids: the desire to accommodate AI-driven load without undermining reliability or driving up power costs.

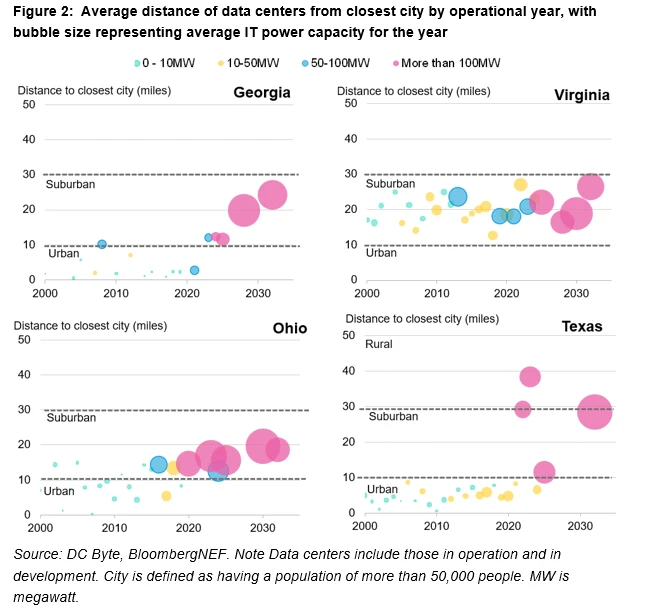

Figure 2: Average distance of data centers from closest city by operational year, with bubble size representing average IT power capacity for the year

At the same time, the geography of US data centers is shifting. The once-dominant market in northern Virginia market is nearing saturation, sending new projects south and west into central and southern Virginia. Georgia is seeing expansion beyond the metropolitan Atlanta area as land and power constraints tighten. Texas is an exception: Developers there are transitioning former crypto-mining sites into AI data centers closer to population centers and fiber routes.

Fiber optic lines and US operating and pipeline data centers

Fiber optics form the digital spine enabling this sprawl, allowing hyperscale campuses to move beyond urban cores while maintaining low-latency performance. Today, developers are building hyperscale campuses in suburban and exurban zones, typically within 30 miles of major cities. Virginia led this transition early, leveraging its strong infrastructure and fiber backbone. Now Georgia and Ohio are following suit as they chase the next wave of digital demand.
